December 10, 2024 was the Power Plant Siting Act Annual Hearing. It was before ALJ Christa Moseng, and there were very few commenters. I’m not seeing any minutes, and don’t know if they’ll ever be posted. There were only two of us commenting, myself, and Dan Wanbeke, who has a CapX 2020 line on his land. If the proposed MN Energy CON line is built, he could be surrounded by transmission.

Wanbeke gave a detailed description of his experience and takeaways, one of the most important was a comment of the PUC’s Bob Cupit (since retired):

A very interesting part of Wambeke’s testimony was regarding the stray voltage problem, all the water in their farm was energized, and the shower tested at 15 VOLTS! The local utility has been out many times, and when Capx 2020 was down for a brief time, no stray voltage, and when it was again energized, the stray voltage was back. He testified about induction current, that when there’s a distribution line running parallel to a massive transmission line, there can be induction current (this also happens with pipelines), and the distribution lines are indeed parallel with CapX transmission. This is NOT rocket science, and the CapX utilities better deal with this. If meeting minutes come out, I’ll post, though the thought occurs to me that this was a “hearing,” so it will probably be a top secret transcript. Will keep an eye out.

These next two tidbits were handouts at the hearing:

And now on to comments filed since:

FYI, the DOT “Policy of Accommodation” that should be entered in every docket, because it sets out how utilities can interact when projects are proposed near roads — I’ve observed cases where the utility paid no attention to DOT comments and landowners nearby were screwed with little notice because utility had to quickly alter plans because DOT would not allow planned placement:

On to the regular folks, so far just two of us!

I’d made oral comments at the hearing (via web), but had to put it in writing to be more specific, because the changes are immense, and there needs to be a record. As I said in my Comment, not for the first time, “I’m disgusted, frustrated, incensed, and committed to showing up before the Public Utilities Commission until I drop dead someday in the large hearing room.” I had to file a corrected version, was bleary-eyed and found typos, missing words and punctuation, and FYI, the first one below has been corrected:

This one, from Kristen Eide-Tollefson for CURE, Communities United for Responsible Energy, is important because she’s seen the changes over the decades, THREE decades, of dealing with the Power Plant Siting Act. Now it no longer exists, hence Eulogy for the PPSA:

Let’s trot out this one again, we’re overdue for a Transmission Transition:

Here it is, and I’ll point out a few things — I really don’t have the stomach for digging into this too deeply, it’s that nauseating.

MTEP24 FULL REPORT

Here is the list of the above projects, with named substations, voltages, and estimated costs (p. 163):

More on this later… I cannot bear to go over this in any detail. 765kV through Minnesota?? URP!

MN PUC – How To eDockets

February 1st, 2024

Who cares about the Minnesota Public Utilities Commission’s eDockets system? We all should care! It’s the best way to keep up with what’s going on in the docket, what others are filing, what issues are being raised, what’s the status, and to track all NOTICES, which will tell you of hearings, comment windows, orders, and pay particular attention to those from PUC, CAH (Court of Administrative Hearings), PUC’s environmental side, and DER (Commerce – the economic side). Also look for comments from individuals and note their concerns.

How to get to eDockets?

GO HERE!!! https://mn.gov/puc/edockets/

Then click on this:

You’ll get to this screen — type in the docket, and use a hyphen as in the example:

Next, for example: At “Docket number” box, just enter the number, i.e., 22-131, and hit search (when there are multiple dockets, a Certificate of Need AND a Transmission Line Routing docket, be sure to check both dockets, one at a time). This works for any docket, like the 800MW RFP docket, E002/CN-23-212, plug in year “23-212” and there you go! Spend some time playing with it to get acquainted, it’ll become second nature soon.

When you get to the docket, as below, click on the far left blue link (it’s a document ID number) in a row to get that filing described in that row. Practice. Do it a few times, and it’ll be quick and easy! If inactive for a while, it will boot you out and you get to start over.

Also, “subscribing” is important to keep up to date on what’s being filed. When there are multiple dockets, be sure to subscribe to them all!

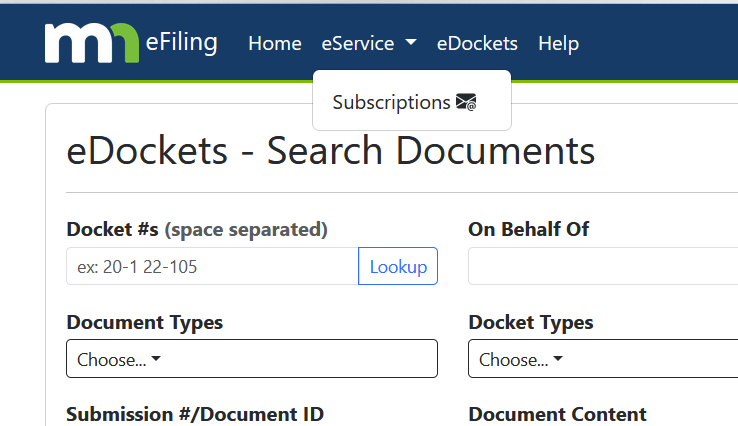

To subscribe, when you get to the docket, look at top of screen, drop down from “eService” and click on Subscriptions:

Follow the directions, and you’re subscribed. You’ll receive notice of filings in the docket, so you’ll always know what’s going on.

When you get emails about the docket, it will have the docket number, and as they come in, pay particular attention to Notices, as there will be dates that are important, meeting/hearing dates, deadlines for comment, etc.

Now, get to it. LOTS of reading, and as you go, you’ll get familiar with it and the process. IT WILL GET EASIER!!

Now for the fun part — FILING IN eDOCKETS! Why file in eDockets? When you file in eDockets, you know what you’ve submitted has been received and is part of the record, and so others can know what your concerns are — it’s SO important to know you’re not alone in this! They’re noted separately in eDockets so it’s easier to find, not buried in a PUC filing of a handful, or hundreds, of comments.

To file, first you have to register. In that first eDockets screen go to upper right corner:

Scroll down to the “Register” link and follow the directions.

Do a test drive after you’ve registered. At “Sign In,” this time sign in, and follow the directions.

As you go through this, note there’s a “HELP” tab at the top, and YES, they are HELPFUL!

WHEN THERE ARE MULTIPLE DOCKETS, BE SURE TO FILE IN BOTH!

Once you take the time to sign up, and get familiar with it, you’ll see how easy it is to keep up with what’s going on, and how easy it is to eFile — and to file last minute!! So easy, I’d be lost but for eDockets and eFiling, you have no idea how awful it was to make paper copies of all filings, and mail them to everyone, whew, it was beyond difficult, and so expensive. Now, it’s a “work from home” easy-peasy process, the best ever change in PUC process, and pretty much everywhere across the country, in administrative proceedings like this, and in most every court system too. Participating, practice, was so much harder so incredibly time consuming before.

Yes, climate change is real…

February 1st, 2024

If you want to learn how to navigate the PUC’s eDockets system:

MN PUC – How To eDockets

I’m working on an overview of “need” for the “MN Energy CONnection” transmission project, Xcel’s latest effort of shifting costs of preserving “valuable interconnection rights” at the Sherco coal plants’ substation. They’ve come up with a plan to run a radial line, yes, RADIAL, from Lyon County up to Sherco, 160-180 miles, AT A COST OF $1.14 BILLION! It’s a brilliant idea, gotta admit… Xcel is the GOAT at planning, BUT it’s such a scam. I do hope we can change the trajectory, get the focus on Xcel, and not be dumping this on the backs of ratepayers and landowners.

Ahhhhh… Xcel’s MN Energy CONnection… In the midst of extreme weather events, I spent time over the last two weeks, seven meetings over four days, for scoping of the Environmental Impact Statement for this project. Here’s the Notice:

Yesterday in Monticello, MN, it was up to 54 degrees! At each of the seven meetings, at least two people waxed histrionically that climate change was not real. How can this be? Granted, 54 degrees and El Nino is “weather” but we all know of the weather extremes, drought, intense storms, that are obvious signs of climate change. Even insurance companies, due to weather extremes, our home insurance doubled (!), and the company said they were doing that for all Minnesota customers (Minnesota focused because we’re in Minnesota!). In Florida, insurance companies are refusing to offer coverage, California too. That article has this pie chart from insurance industry:

Granted, it’s focused on perception of when your “home” will be affected, and not LIFE, but according to the insurance industry, so many say “no effect” and I’ve heard enough denial of climate change lately to think that the pie chart is credible. Insurance companies make money on their gambles, and if you’re insuring anything, you’re betting against the house.

Sherco 3 IS closing. Xcel wants to build this transmission below, and have ratepayers and landowners pay for it. The purpose of this is to preserve Xcel’s “valuable transmission interconnection rights” at Sherco.

I don’t think so…

FYI: MN PUC – How To eDockets

The last two weeks have been scoping meetings for the Environmental Impact Statement for the “MN Energy CONnection.” Per Xcel’s site, “You can read the Certificate of Need filing here and the Route Permit application here.” I don’t see the word “REVISED” on this…

Here’s the REVISED Certificate of Need application:

And here’s the Route Application:

Route-Application App C are the maps — TOO LARGE — see eDockets

So many people getting notice of the “MN Energy CONnection” transmission line have CapX 2020 in their yard, and they are PISSED! It was standing room only last night in Litchfield, 100 of my flyers gone and folks were still filing in. Again this morning in Monticello, over 100 again:

Several this morning brought up EMF and the magnetic fields. The magnetic fields from the “REVISED” application are cause for concern — look at their modeling levels shown for the edge of the Right of Way:

Anyway, there’s a lot tocomment about, things that should be included in the EIS. But now’s not the time to write. More later.
